Estimation errors kill software projects. Indian dev teams underestimate by 50-100%, budgets blow out, timelines slip, and stakeholder trust evaporates. But 70% of projects have difficulty with accurate estimation, with scope creep related to 45% of project failures and unrealistic deadlines associated with 38% of delays. The cost to business is staggering—bad estimation is what drives cost overruns, missed deadlines, and abandoned projects, and it costs the software industry billions every year.
This end-to-end guide lays out battle-tested frameworks for Indian team app development project estimation through relative estimation via story points, three-point estimation with confidence bands, strategic risk buffers, disciplined change control processes, and transparent reporting rhythms. Whether you’re a startup founder planning your MVP, a product manager working with offshore teams, or an enterprise PMO setting estimation processes, this post offers actionable approaches to turn estimation from guesswork into science!
Traditional hour-based estimates are broken, but why? That understanding provides a foundation for what comes next in modern estimation.
Productivity amongst individuals varies wildly. A senior developer may accomplish in 4 hours what a junior developer needs 20 to finish. Such disparities between teams cause perpetual friction when estimating by hours – do we estimate hours in senior-level or junior-level skills? Time-based estimation promotes awkward conversations about individual availability that harm team cohesion.
Exactness results in false certainty. Saying “this feature will take 47.5 hours” is a level of precision that just doesn’t exist in the inherently uncertain world of software development. Clients treat precise estimates as commitments, and expectations are set accordingly, even if reality rarely complies. The precision paradox: More precise estimates feel more reliable (even though they are equally uncertain), which causes less reliable estimates to bring broken promises and damaged relationships.
Estimates turn into quotas. Once you start estimating hours, those hours become targets, and developers feel pressured to meet those, regardless of the actual complexity of the work. It puts pressure to cut corners, not to test, and add tech debt to “hit the estimate” even when the estimate is wrong!
Context switching isn’t factored in. Hour estimates assume a focused one-brain session, but life is full of meetings, emails, code reviews, deployments, support issues, and context switching that eat between 40 and 50 percent of your day. The actual time is that productive coding time is rarely more than 4-6 hours a day, even in 8-10 hour workdays.
Learning curves are ignored. The first time you implement authentication with a new framework takes a lot longer than the fifth. Estimates in hours don’t handle learning well — they make teams busy either by grossly padding estimates (and looking inefficient) or consistently underestimating (and missing deadlines).
Modern methodologies for estimation—such as story points and three-point estimation—mitigate these shortcomings by adopting relative sizing, accounting for uncertainty, and shifting focus from individual hours to team capacity.
Story points are a measure of the overall effort needed to develop a user story, feature, or work item, considering complexity, risk, and uncertainty, and the amount of work.
Similar, not absolute. Story points estimate work relative to other work, not as a definitive amount of time. A 5-point story represents approximately 2.5 times the work of a 2-point story; whether that equates to 5 hours or 15 hours depends on who is doing the work.
This relativity takes the heat out of conversations comparing productivity – the team as a whole agrees Story A is ‘about twice as complex’ as Story B, and that’s the end of it, without bringing Maria’s coding speed into question compared to Raj’s.
Consensus-based. Story points are the result of team discussion and consensus, most commonly using planning poker or other estimation games. When five teammates each make an estimate of a feature and four estimate “5 points,” but one person assesses it at “13 points,” the dissenting opinion surfaces concerns others had not considered and ultimately makes for a stronger, more accurate collective estimate.
Velocity enables forecasting. Once teams finish sprints, their velocity — the mean number of story points completed per sprint — becomes consistent, allowing for accurate forecasts. A 40-point velocity team will need about 5 sprints to complete a 200-point project, no matter what the hour estimates for the individual stories.
It’s more than just writing code. Story points represent design, development, testing, code review, documentation, deployment, and anything else needed to get work “done.” This view of the world eliminates the classic trap that “coding is done,” but the feature is not shippable for days because there is still testing and deployment work.
Accounts for uncertainty and risk. An 8-point story may require the same amount of coding as a 5-point story, but it is given a higher point value due to uncertainty about how a third-party API will work or the risk of introducing browser compatibility issues. Points inherently capture these intangible elements that plain hour estimates can’t capture.
Teams use different scales for story points, with different tradeoffs
The Fibonacci scale (1, 2, 3, 5, 8, 13, 21…) is the most popular, with 25% of agile teams who use it. The increasing gaps between the numbers are meant to represent that estimation is becoming less accurate with increasing complexity—it’s easier to tell the difference between 1 and 2 points than 20 and 21.”
The extended scale is used for larger work items (1, 2, 3, 5, 8, 13, 20, 40, 100) and is commonly referred to as the Modified Fibonacci sequence, although 35% usage makes it the most popular scale. The leap up from 13 to 20 (instead of 21) and 20 to 40 (instead of 34) helps in grouping estimation in distinct folders.
Linear scales (1, 2, 3, 4, 5) offer naïve simplicity but erroneously suggest that the same level of accuracy is maintained across the scale. Used by 15% of teams, linear scales are the most suitable for teams beginning to work with story points, as they may find Fibonacci difficult to understand at first.
T-shirt sizing (XS, S, M, L, XL, XXL) provides qualitative buckets and is less scary than numbers, 20% adoption mainly by non-technical users who found numeric abstraction intimidating. T-shirt sizes are then converted to numeric points to calculate velocity (XS=1, S=3, M=8, L=16, XL=30).
Powers of 2 (1, 2, 4, 8, 16, 32) is popular among technically inclined teams due to the “doubling” pattern they appreciate, still has under 10% adoption.
Effective story point estimation has a ceremony-like feel:
Step 1: Define baseline stories. The team chooses 2-3 stories as story points at different levels of complexity in the form of anchors. These are the yardsticks to which every subsequent story is compared.
For example, a team might define:
These baselines and the rationale are documented so new members of the team can understand what the scale of reference is.
Step 2: Read the user story. The product owner presents the story, business context, and acceptance criteria, and also addresses questions for clarification. Estimates are as good as the clarity of the story – fuzzy requirements lead to bad estimates.
Step 3: Estimate individually. Team members estimate the story independently relative to the baseline stories and, without discussion, select their estimate. It avoids anchoring bias, where the first person’s estimate sets the tone for everyone else.
Planning poker cards or similar objects with numbers (often Fibonacci numbers) are a shared tool, and each participant selects their estimate card face down.
Step 4: Reveal and discuss. All participants reveal their estimates at the same time. If there is agreement (everyone picks the same or neighbouring values), that is the estimate. If there is a large divergence (some estimate 3 and others 13, for example), the lowest and highest estimators justify their estimates.
These discussions help reveal hidden complexity or misunderstandings within the team. The person who estimated 13 may have assumed “we need real-time updates via WebSockets,” and the person who estimated 3 assumed simple polling. Clarifying assumptions leads to better estimates.
Step 5: Re-estimate if needed. Following the discussion, the team reaches a consensus on a re-estimation when applicable. Most stories achieve consensus within 2-3 rounds. If consensus can not be reached, this indicates that the story should be further cut down into smaller chunks with more clearly defined boundaries.
Step 6: Document and commit. The agreed-upon story points are recorded in the project management tool (Jira, Azure DevOps, …), and the story is moved to the sprint backlog if prioritized.

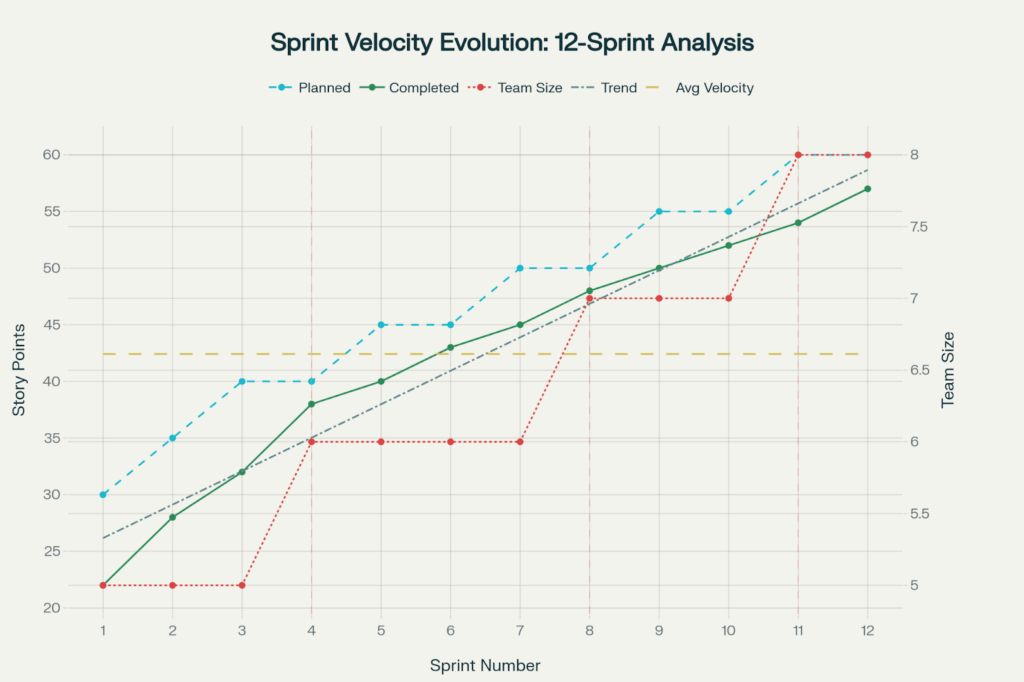

This velocity chart shows the growth and stabilization of the team over 12 sprints, indicating how completed story points increase from 22 to 57 as the team matures and gains in estimation accuracy.
Velocity—how many story points the team completes per sprint—evolves 3-5 sprints predictably as teams tune their estimates and find a sustainable pace.
Initial sprints show volatile velocity. Sprint 1 might produce 22 points, Sprint 2 produces 28, and Sprint 3 produces 32 – this variability is due to the learning process as the teams fine-tune their estimates, calibration, and discover their real capacity.
Velocity is stable around sprint 3-5. Usually, velocity converges within a band of 10-15% by the 4th or 5th sprint. It’s not unusual for teams to deliver a consistent 38 to 43 points and average 40 points per sprint, for that matter.
Velocity per person is normalized. When you divide total velocity by team size, you get a useful per-person metric for comparing to when team size varies. When a six-person team increases to eight, if the original team found current velocity to be 42 points (7 points per person), project initial velocity around 48-56 points as new members ramp up to the 7-point average.
Velocity allows you to make predictions. With a steady 40-point velocity, a 200-point backlog would take 5 sprints. A product roadmap with 500 points requires 12-13 sprints. These projections presume the team membership remains constant and no major disruptions arise.
Velocity is descriptive, not directive. Making velocity a success metric to maximize leads to dysfunction – teams pad estimates or forgo quality practices in the name of “velocity.” Velocity reflects what is possible; it should not govern what is done. A team with a steady 35-point velocity with quality software delivery is better than a team “getting” 60-point velocity through bad code that needs to be rewritten constantly.
Converting points to hours undermines the process. Some teams estimate in points, then multiply by hours per point to derive hour estimates. This brings back all the problems of story points, plus adds conversion overhead. When you want hour estimates, go with the three-point estimation below instead.
Comparing velocity between teams creates toxicity. Team A’s 50-point velocity is “not better” than Team B’s 35-point velocity—it’s just not comparable. Different teams, codebases, and stories make cross-team velocity comparison useless.
Fractional points provide false precision, added complexity, and no value. Other teams are doing half-point increments (0.5, 1.5, 2.5, and so on) because they think it makes the estimates more precise. The added complexity isn’t really worth the little bit of accuracy you get. Simpler scales work better.
Estimating too far in advance wastes effort. Only estimate stories that are likely to be in the next 2-3 sprints. Estimating a full 6-month backlog adds false precision because requirements will change and team velocity will evolve. Rolling estimates – ie, estimating 2-3 sprints into the future at any given time – strike a balance between planning requirements and agile responsiveness.
Three-point estimation accepts that single value estimates disregard the uncertainty, and it requires three scenarios: optimistic, most likely, and pessimistic.

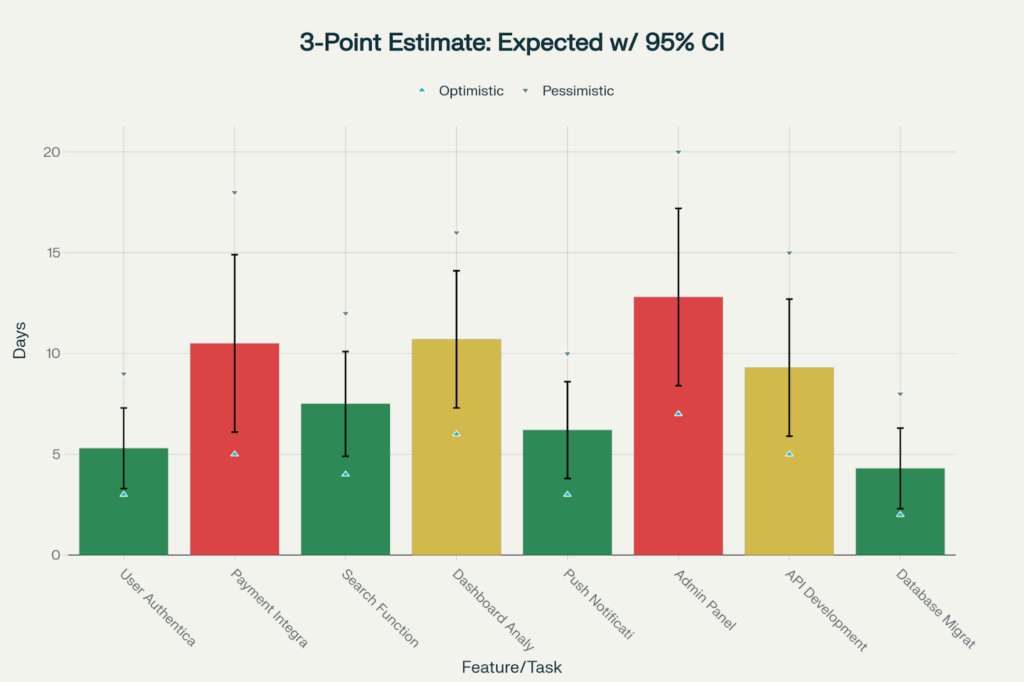

This graph shows how the three-point estimation gives confidence intervals with payment integration having the widest uncertainty (6.1 – 14.9 days) due to third-party dependencies.
Optimistic estimate (O): All goes well in this best-case scenario—APIs behave exactly as documented, no surprises pop up, testing unearths a few bugs, and the team remains laser-focused. This is approximately the 10th percentile result—reality will be better than this estimate 10% of the time.
Most likely estimate (M): The most realistic expectation for the amount of work involved based on experience from teams performing similar work and known level of interruptions compounded by a reasonable expectation for normal complications. This represents the 50th percentile outcome—reality will be faster half of the time, and slower half of the time.
Pessimistic estimate (P): Worst-case scenario, Murphy’s Law is in full effect: third-party APIs are intermittently down, new browser bugs are found, essential team members fall ill, and everything takes way longer than anticipated. This is approximately the 90th percentile result—reality will be worse than this estimate 10% of the time.
The magic of the three-point estimation is in a distributional formula that applies a weighting to these three values to calculate an expected duration that considers the natural optimism bias in planning.
The Program Evaluation and Review Technique (PERT) is used to estimate the expected time duration by considering the most probable time:
Expected Duration (TE) = (O + 4M + P) / 6
This weighted average reflects that the most likely outcome is considered to happen, whereas the best and worst cases are tails of the distribution.
Example: Payment gateway integration
Expected Duration = (5 + 4×10 + 18) / 6 = (5 + 40 + 18) / 6 = 63 / 6 = 10.5 days
This estimate of 10.5 days turns out to be more reliable than a single-point “10 days” since it takes into consideration the awareness of risk.
The standard deviation measures the uncertainty, by how much the real outcomes could deviate from the expected value:
Standard Deviation (SD) = (P – O) / 6
For the payment gateway example:
SD = (18 – 5) / 6 = 13 / 6 = 2.17 days
Standard deviation allows for the calculation of confidence intervals, which provide an estimate of the interval in which the true duration will probably be:
68% Confidence: TE ± 1 SD (10.5 ± 2.17 = 8.33 to 12.67 days)
95% Confidence: TE ± 2 SD (10.5 ± 4.34 = 6.16 to 14.84 days)
99.7% Confidence: TE ± 3 SD (10.5 ± 6.51 = 3.99 to 17.01 days)
Following standards, the industry applies a 95% confidence to project planning; you are 95% sure the actual duration falls within the range.

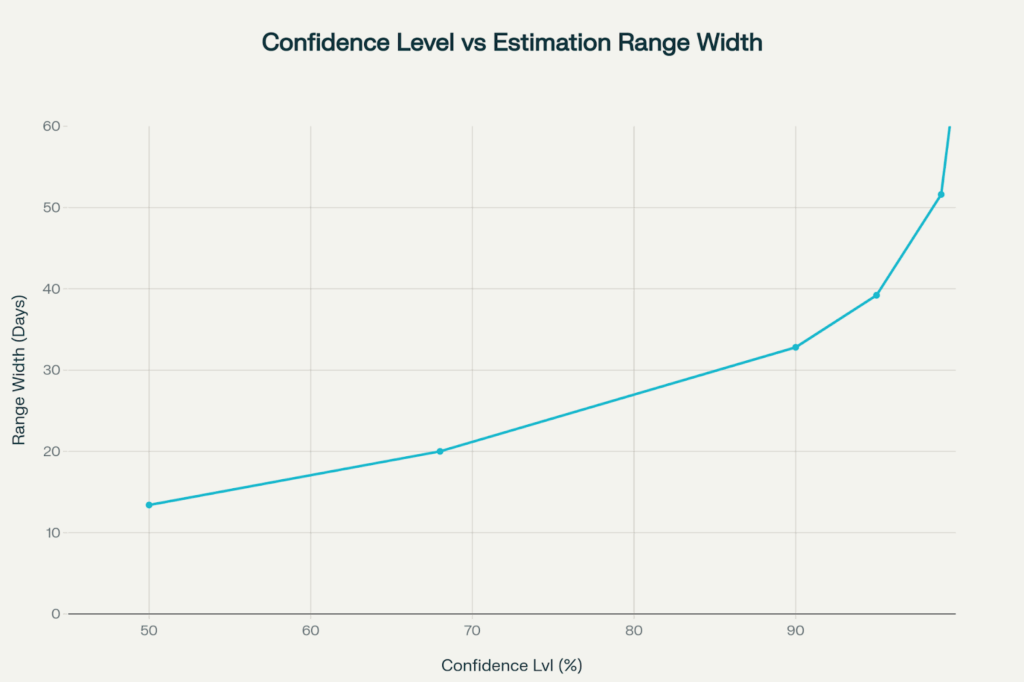

This figure shows that increasing confidence leads to wider intervals for estimates, with 95% confidence being almost three times wider than 50% confidence for the same estimate.
Split the work into manageable tasks. Three-point estimates are most suitable for work packages that are small enough to be estimated meaningfully at three points (usually in the range of 2-20 days of work). Work of a greater size must first be divided into subtasks
Estimate each task in O, M, P. For each task, the team makes three estimates. Promote realistic, pessimistic estimation — “worst case excluding aliens invade Earth” covers 90th percentile risk and won’t look like craziness.
Compute expected durations and standard deviations. Use PERT calculations for all activities to obtain their expected durations and standard deviations.
Sum up to the project level. Sum the expected durations for all tasks to get the expected duration for the entire project. For the standard deviation, use this equation:
Project SD = √(SD₁² + SD₂² + SD₃² + … + SDₙ²)
It can be understood that uncertainties of tasks are diversified at the project level.
Present range, not point estimate. Communicate estimates as ranges: “This project will take 85-95 days at 95% confidence with an expected duration of 90 days.” This visibility better manages the stakeholder expectations than false precision.
Visibility into risk. Standard deviation can be used to identify high-risk work with large pessimistic and optimistic ranges. These activities require additional focus, contingency, or prototyping to mitigate uncertainty.
Realistic planning. Adding a 50% padding to estimates seems like an arbitrary number, but the statistically calculated confidence intervals provide a justified padding. Stakeholders are more willing to buy into a “95% confidence range” than “I added a 50% padding”.
Better communication. Ranges do not attempt to hide the inherent uncertainty, pretending to know how precise they are. That honesty engenders trust with stakeholders who enjoy enough blown deadlines to value transparent probability.
Higher-quality decisions. When you see a task that has a pessimistic estimate so much higher than the most likely guess, this is a signal that you may want to clarify the requirements, do some technical prototyping, or explore other options prior to investing resources in it.
Even the best estimates are subject to the vagaries of unforeseen problems and delays, which cost both time and money. Strategic risk buffers add cushion to absorb shocks without derailing projects.

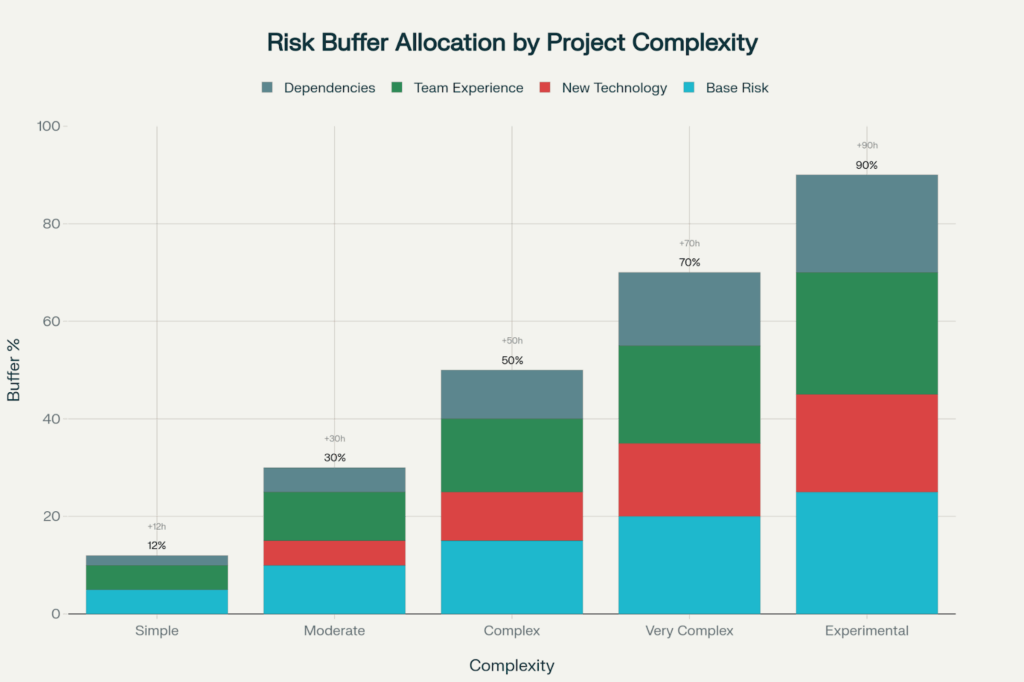

This stacked graph illustrates how risk buffers increase proportionally with project complexity, from 12% for straightforward projects to 90% for experimental work involving new technologies.
Risk of Complexity increases with architectural complexity, technical unknowns, and integration. Simple CRUD applications need a very small buffer (5%), while complex microservice architectures with multiple third-party integrations require 15-25% buffers.
New technology risk arises when teams adopt new frameworks, languages, or infrastructure. First time using React Native or going serverless architecture brings a learning curve overhead. Buffer 5-20% based on team maturity and technology development.
Team experience risk describes shortfalls in ability (for example, an inexperienced team, one which has seen high turnover, or multiple co-located teams that aren’t used to working together get 10-25% buffers to account for learning, miscommunication, and rework.”
Dependency risk is magnified when projects are dependent on external elements: stability of a third-party API, content/data provided by a customer, regulatory approval, and deliverables from other teams. Each critical external dependency adds between 2-10% buffer.
Uncertainty of requirements risk increases when the scope is fluid, stakeholders are unable to articulate a clear vision, or the market is likely to influence priorities. Prototype / MVP projects in an uncertain domain need 15-30% buffers to cater for pivots.
Instead of arbitrary padding, systematic risk assessment yields justified buffers:
Project example: Simple mobile app with known tech stack, seasoned team, well-defined requirements, no critical dependencies
For a 1,000-hour base estimate, add 120-hour buffer = 1,120 total hours
Example of a complex project: Enterprise integration platform leveraging microservices, greenfield cloud-native design, mixed experience team with numerous third-party integrations, changing requirements
For a 1,000-hour base estimate, add 750-hour buffer = 1,750 total hours
This 75 percent buffer is likely to rile up stakeholders, but it captures real ambiguity in a risky endeavor. Rather than narrating a 70%& overrun in the middle of the project, better to tell realistic timescales up front.
In addition to project-specific risks, there are general productivity drains that consume 15-25% of the available time on all projects:
Meetings: Sprint ceremonies and meetings with stakeholders, design reviews, and architecture discussions take up 10-15% of developers’ time.
Context switching: Switching between different tasks, being interrupted by “quick questions”, build failures, and impromptu support requests breaks the flow of thought and decreases productivity by 10-20%.
Communication gaps: Distributed teams experience rounds of clarification—the developer implements interpretation A, while the client wanted interpretation B, resulting in rework.
Variation in productivity: People aren’t robots. Being sick, burnt out, going through life events, and motivation swings all create a natural variance in how productive you are.
Learning and Troubleshooting: Even veteran developers on a familiar platform will need to research, debug unexpected problems, and learn about edge cases with traditional tools:
Add 20–25% to incorporate these all-encompassing time suckers in addition to your project-specific risk buffers.
Final project duration formula:
Project Duration = Base Estimate × (1 + Risk Buffer) × (1 + Time Eaters)
For the complex project above:
1,000 hours × 1.75 (75% risk buffer) × 1.20 (20% time eaters) = 2,100 hours
This may seem like overkill, but research shows it corresponds with what happens on high-risk projects much better than taking estimates at face value.
Even the best initial estimates become stale when the scope changes. Disciplined change control processes prevent chaos and allow for legitimate needs.

This bubble chart reveals the negative correlation between change impact and approval rates, with scope expansions averaging 35 days but only 20% approval, despite a 40% budget impact.
Scope creep is a timeline killer. Research indicates that 45% of project failures are attributed to scope creep — an incremental increase in project requirements without proper adjustment to time, cost, and resources. Minor “quick adds” snowball over the course of weeks or months of unanticipated work.
Prioritization is infeasible. In the absence of formal change processes, everything is a priority. The teams bounce back and forth between competing priorities, ending up not doing anything as they try to do everything.
Trust erodes. When customers demand changes, thinking they’re little things, but developers know they’re weeks of work, friction arises. Change control exposes the impact and avoids these relationship-damaging surprises.
Quality suffers. Runaway changes cause developers to speed up and cut corners on testing, and to take on technical debt in order to make deadlines. Change control guarantees sufficient time for the change to be implemented adequately.
Step 1: Submit the change request. Change requests can be submitted by any (client, product owner, developer, stakeholder) using standardized forms capturing:
Standardized forms allow for uniform information, which facilitates the ability to make an informed assessment.
Step 2: Log and categorize. The project manager logs each change request, assigns a unique ID (CR-2025-047), and classifies the severity:
Classification defines the approval process – trivial changes might not need to go through a formal CCB review, while significant changes need to be approved by the Executives.
Step 3: Assessment of the impact. The development team assesses the impact of change along several axes:
This evaluation takes 2-8 hours for minimal modifications, 1-2 days for substantial modifications. The assessment issues a recommendation: Approve, Reject, or Defer (revisit post-launch).
Step 4: Review and decision. The Change Control Board (CCB) – usually product owner, project manager, technical lead, and client representative – evaluates the impact assessment and determines:
For moderate and major changes, the CCB meetings are held either weekly or biweekly. For minor changes, the head of the project alone may grant approval (simpler procedure).
Step 5: Implementation. Accepted changes go into the backlog, get story point estimates, and are prioritized as any other work. If the change is worth an emergency fix, the lower-level stuff is put off to maintain the overall scope.
The team develops the change using the regular development lifecycle – design, code, test, review, deploy.
Step 6: Verification and closure. When it’s done, the submitter checks that the change meets their expectations. The change request is then closed with documentation of actual effort vs estimated effort for use in future impact assessments. Dissatisfied, clarifications or modifications are made prior to closure.
Set clear levels. “In scope” vs “change request” is established at the start of the project. A good heuristic: If it involves more than 2 hours of work or wasn’t specifically part of the original requirements, it is a change request.
Make this a lightweight process for small changes. Bureaucracy destroys agility. Small modifications should be routed through analysis and approval in 24-48 hours via simplified forms and pre-identified decision makers.
Combine changes logically together. Instead of evaluating 12 individual changes, organize related changes (a “Mobile app UI polish bunch”) and review them as a group. It speeds up the review and gives the real cumulative effect of them all.
Be transparent with change logs. All parties involved in a project need to be able to access the status of a change request—what has been pending, approved, or rejected. in the works. This transparency can prevent what I call “I thought you were doing X” surprises in projects.
Associate changes with outcomes, not with features. Are you with me so far? “Don’t talk about how a device actually benefits the user. Instead, speak to business value, user outcomes, or technical necessity, not “I need this feature.” Instead, consider the business value, outcomes for users, or technical need, rather than “I want this feature.” This changes the focus of assessment to impact, away from being based on preferences.
Allocate capacity for changes. Realistic projects anticipate 10 to 20 percent of their effort used for in-sprint changes and refinements. Don’t push the sprint to 100% capacity; leave a buffer for uncertainties.
Monitor shift trends. It’s also useful to know if one stakeholder is driving 60% of the changes, or if a particular feature is generating an unusual amount of changes; these are indications that there are problems with the requirements that may warrant further analysis.
Transparent and predictable reporting avoids surprises, builds trust, and allows for course correction before issues become crises.

This reporting summary shows that sprint planning and reviews take the most time (60-90 minutes) but are rated the highest importance, and daily standups run most efficiently at 15 minutes.
Daily Standup (15 minutes): The team synchronizes on progress, plans, and blockers. Three questions
Standups are not status reports to managers— they are team synchronization to avoid duplication and bring up blockers that need assistance.
Burndown chart updates (5 minutes): The sprint burndown chart tracks the sprint backlog, charted daily for the number of hours remaining. A good burndown is a smooth, steady decline. If the burndown flattens or goes back up, it’s a sign of trouble that needs to be dealt with.
Sprint Review (every two weeks for 60 minutes): The team shows its completed work to the stakeholders, collects feedback, and confirms that needs are satisfied by the delivered features. Rally reviews aren’t formal presentations—they’re working sessions when you can actually engage with the software and get real reactions from the stakeholders.
Recording sprint reviews creates material for future discussions and enables distributed stakeholders to attend asynchronously.
Sprint retrospectives (45 minutes every 2 weeks): The process of the reflection of the team over the process, detailing what’s working well and what needs to be improved. Retrospectives are the engines of continuous improvement — without coevolving process changes, velocity will never stabilize.
Good retrospectives are based on the start/stop/continue model: What should we start doing? What can we stop doing? What should we continue doing?
Velocity reports (30 minutes per sprint): The project manager reviews sprint velocity by: how many story points were planned vs how many story points were completed per sprint; tracking velocity trends; updating forecasts. Velocity reports expose patterns— Is velocity declining? Has the team been consistently under- or over-committing? Are there certain types of stories that take longer than estimated?
Weekly updates to stakeholders (30 minutes): Client or product stakeholders are provided with progress summaries on:
A weekly cadence keeps stakeholders engaged without inundating them with daily granularity.
Monthly executive summaries (45 minutes): Senior leadership is provided a high-level dashboard that includes:
Executives don’t need sprint-level details—they need to be strategically aware and have early visibility into concerns that will need their attention.
Budget variance reports on a monthly basis (30 minutes): Finance and management analyze actual expenditure against the budget, discussing variances and revising the forecast. Budget reports should provide explanations for variances (approved changes, velocity adjustments, risk materialization) and not only numbers.
Assessment of Sprint-Level Risks (Every 2-3 sprints, 60 minutes): The team and the project manager hold a formal review of:
Risk assessments eliminate surprises by keeping a constant eye on threat and mitigation documents to ensure they are up to date.
Together, these methods can develop into a complete estimation discipline:
Phase 1: Initial Estimation
Phase 2: Sprint Planning
Phase 3: Execution and Monitoring
Phase 4: Sprint Closure and Learning
Phase 5: Reporting
This process instills discipline yet avoids bureaucracy, melding quantitative rigor with nimble responsiveness.
For working with an Indian development team, some unique challenges pertain to estimation:
Communication gaps increase the impact of estimation errors. Minor misunderstandings of requirements, which would be caught immediately in co-located teams, linger across time zones and language barriers. Spend some extra time on getting the requirements clear and on providing visual documentation (wireframes, flowcharts, prototypes) to decrease ambiguity.
Cultural biases to optimism. Studies suggest Indian professionals may give optimistic estimates to please clients rather than realistic estimates. Create an environment where “that took longer than we thought” is rewarded, not punished. Thinking in terms of Three-point estimation is useful because it explicitly asks for a pessimistic scenario.
Under different baseline assumptions. The “simple” for an Indian team might be very different from your “simple” based on differing experience with tech stacks. Spend time creating common baseline stories that are known to both parties in the exact same way.
Velocity stability in the face of team changes. There is more turnover in the Indian IT industry than in the US/Europe. When people depart a team in the middle of a project, its velocity takes a temporary hit as new people come up to speed. Buffer Your Velocity: Add a 10-15% Velocity buffer to compensate for attrition.
Holiday and festival effects. The Indian calendar covers major festivals (such as Diwali, Holi, etc) when productivity takes a deep plunge. Incorporate these into your capacity planning, rather than being caught off guard by sudden reductions in velocity.
Good estimation turns software projects from wishful chaos into orderly delivery. Story points integrate the relative sizing and team consensus, remove the illusion of precision and the toxicity of comparing productivity in terms of hours estimates, and allow forecasts driven by velocity. Three-point estimation takes into account uncertainty explicitly, with statistically valid confidence ranges that set a realistic expectation for risk for shareholders. Strategic risk buffers are a shield against the unknown, where calculation is systematic rather than the precursors of padding. Disciplined change control stops scope creep chaos but still flexes for legitimate requirements via transparent impact analysis. Steady reporting cadence informs all parties at the right level of detail to help ensure no one is blindsided and everyone has the opportunity to course correct.
It is these methodologies that are more crucial when one is working with Indian development teams. Communication barriers, cultural differences, and physical distance exacerbate estimation errors that sound frameworks mitigate. Teams that popularize estimation best practices, establish baseline stories, calculate realistic buffers, maintain velocity tracking, and handle changes through a formal process tend to dominate those that base their estimates on intuition or hope.
The path to estimation accuracy isn’t perfection on sprint one. It’s a matter of process, learning along the way from what actually happened, and transparent communication about uncertainty. Teams that track velocity over 5+ sprints, monitor estimation accuracy, and recalibrate their estimates get exponentially better. Those who see estimates as commitments etched in stone, as opposed to forecasts open to amendment through learning, are the ones who permanently find difficulty.
Start simple: do story point estimation for your next sprint, pick a risk buffer for your next project, and set up simple change control. Evaluate outcomes, learn from variances, and gradually take on more complex methods. Within 3-6 months, your estimation accuracy will improve 40-60%, turning projects from putting out fires to predictable delivery that delights stakeholders and sustains team spirit.
